Tarot deck print lead time: how long it takes (2026)
Tarot deck print lead time runs from a few days for a single print-on-demand copy to 8 to 12 weeks for an offshore offset run, before freight. A small run at MakePlayingCards lands in roughly 2 to 4 weeks. A 100 to 500 copy offset order takes 4 to 6 weeks. The moment you add a proof, add another cycle.

That last part is where most first-time creators get burned. The press time is the number printers advertise. The delivery date is the one your backers and buyers actually see.
What is a realistic tarot deck print lead time?
Lead time depends almost entirely on which type of printer you use, and the gap between the fastest and slowest is enormous. A no-minimum digital shop can hand you one deck in days. An offset printer making a thousand copies is a multi-week industrial job, and the boat carrying them adds weeks more.
Here are 2026 planning estimates for a standard 78-card deck. Treat them as starting points and confirm the real window with a live quote before you promise anyone a date.
| Printer / type | Typical run | Turnaround (as of 2026) | Notes |
|---|---|---|---|
| Print-on-demand (DriveThruCards, The Game Crafter) | 1 copy | a few days to ~1 week | Prints on order, ships from their facility |
| MakePlayingCards (MPC) | small run | ~2 to 4 weeks | Digital; production plus international shipping |
| US / offset short run | 100 to 500 | ~4 to 6 weeks | Domestic freight, no ocean transit |
| PrintNinja and similar offshore offset | 500 to 2000+ | ~8 to 12 weeks + freight | Cheapest per deck, longest wait |
The pattern is simple. The cheaper the per-deck price, the longer you wait. Print-on-demand costs the most per copy and arrives fastest. Offshore offset is the cheapest deck you can make and the slowest to reach your door. You are trading money for time in both directions.
Why does a proof add weeks to your print lead time?
A proof is a single physical copy the printer makes so you can check color, cardstock, and cutting before committing to the full run. It is the cheapest insurance in self-publishing, and it is also a whole extra loop in your schedule.
Ordering a proof means the printer produces it, ships it to you, and then waits. You inspect it, catch the color shift or the crooked back, request a fix, and only then approve the run. Each of those steps is days. A single proof cycle commonly adds 1 to 3 weeks to your total tarot deck print lead time, and more if you need a second proof after changes.
Do not skip it to save time. The r/TarotDecks regulars are near-unanimous: colors move between screen and card, stock feels different than you pictured, and a bad run of 500 decks is far more expensive than a two-week delay. Build the proof into the plan from the start. For the full picture on when and why, see whether you need a proof before your print run.
How do you count backward to a launch date?
Count backward from the day decks must be in hand, not from the day the press starts. This is the single mistake that wrecks Kickstarter fulfillment timelines and product launches.
Freight is the hidden killer. An offshore offset order might quote 6 weeks of production, then spend another 4 to 8 weeks on a boat, in customs, and on a truck. If you promised backers a delivery month based on the 6-week press quote, you are already two months late before anything goes wrong.

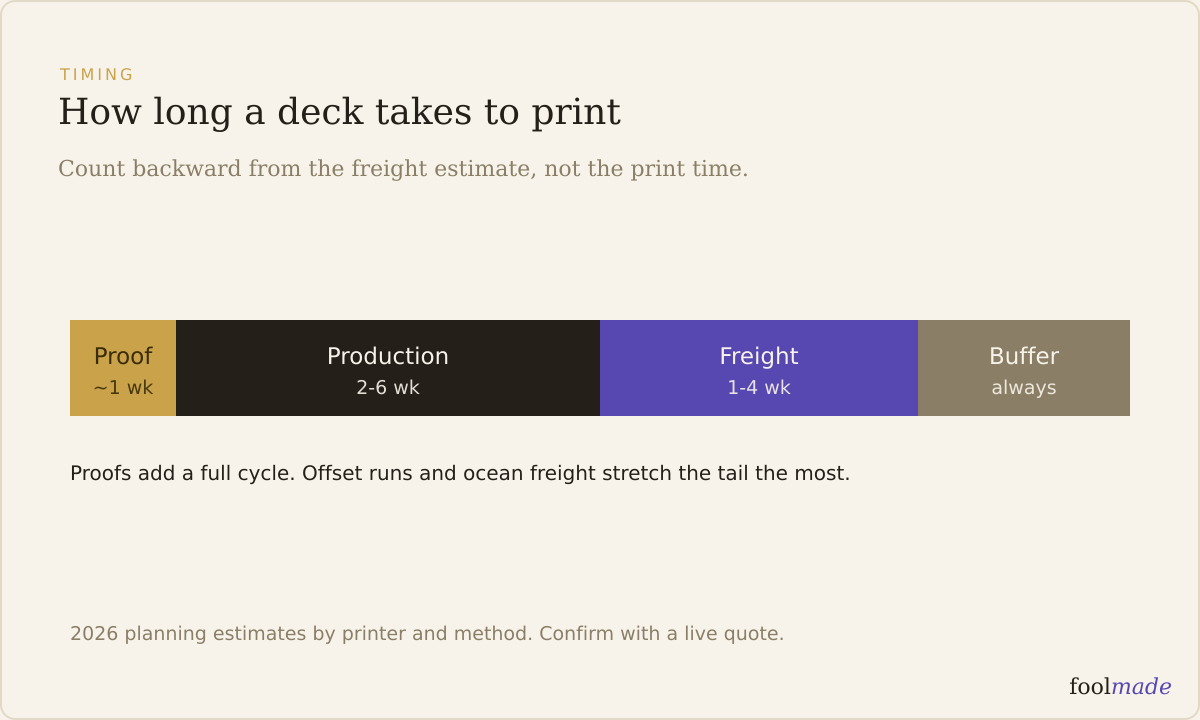

Work the timeline in this order, from your target delivery date backwards:
1. Delivery buffer. Add 1 to 2 weeks for the unexpected. Something always slips.
2. Freight and customs. Days for domestic, 4 to 8 weeks for ocean shipping from an overseas printer.
3. Production run. The number the printer actually quotes you.
4. Proof cycle. 1 to 3 weeks per round, and assume at least one round.
5. File prep and fixes. Time to correct anything the proof reveals.
Add those up and you have the real date. For an offshore run with a proof, a safe planning window is often 3 to 4 months from approved files to decks in your hands. For a domestic short run, 6 to 10 weeks is more typical.
Which is fastest if you are in a hurry?
Print-on-demand, every time. If you need a deck this month, order from a no-minimum digital shop that prints and ships on demand. You will pay the most per copy, but you skip the run, the freight, and most of the wait.
| If you need decks in... | Best route | Realistic cost trade |
|---|---|---|
| 1 to 2 weeks | Print-on-demand, single or few copies | Highest per-deck price |
| 3 to 5 weeks | MPC or a domestic short run | Middle ground |
| 2 to 4 months | Offset, 500+ copies | Cheapest per deck, longest wait |
For a first deck, the speed of print-on-demand doubles as risk control. You hold one real copy, learn what needs fixing, and only then commit to a bigger, slower, cheaper run. If cost is driving the decision, the full breakdown of what it costs to print a deck shows exactly where the per-unit price falls with volume, and how much you pay for going fast.
Choosing between shops matters here too, because their default turnarounds differ. The comparison of MPC, The Game Crafter, and DriveThruCards covers which one fits a rush versus a bulk run, and the wider guide to where to print your indie tarot deck maps the full field.
Frequently asked questions
How long does it take to print a tarot deck on demand?
A single print-on-demand copy from a shop like DriveThruCards or The Game Crafter typically prints and ships within a few days to about a week. It is the fastest route because there is no run and no freight, just one deck made when you order it.
How long does an offset tarot deck print run take?
An offshore offset run of 500 or more decks usually takes 8 to 12 weeks in production, then several more weeks for ocean freight and customs. Plan for 3 to 4 months total from approved files to decks in hand.
Does ordering a proof delay my print run?
Yes, and it is worth it. A proof adds roughly 1 to 3 weeks per round because the printer makes it, ships it, and waits for your approval before starting the full run. Budget for at least one proof cycle.
When should I place my print order for a launch?
Count backward from your delivery date, not the print date. For an offshore run with a proof, order 3 to 4 months ahead. For a domestic short run, 6 to 10 weeks is usually safe. Your launch day plan should be built around the delivery date, never the press date.
Can I speed up a tarot deck print lead time?
Somewhat. You can pay for rush production or faster shipping, use a domestic printer to skip ocean freight, or switch to print-on-demand for immediate small quantities. You cannot safely skip the proof.
The honest bottom line
The number a printer advertises is press time. The number that matters is the day decks reach you. Between those two sits the proof cycle, the freight, and customs, and that gap is where launch dates die.
Pick your route by your deadline first, then your budget. If you have months, offset rewards the wait with the lowest per-deck cost. If you have weeks, print-on-demand costs more but never leaves you apologizing to backers.
If you are lining up a run and want the timing and the money to line up together, Foolmade's margin planner lets you map your print route, run size, and target price so you can see the cost and plan the schedule before you commit a dollar. Foolmade never prints your deck or generates your art. It just helps you plan the run you order yourself.
